Hybrid Methods to Solve the Two-Stage Robust Flexible Job-Shop
Scheduling Problem with Budgeted Uncertainty
Carla Juvin
1
, Laurent Houssin
1,2 a
and Pierre Lopez
1 b
1
LAAS-CNRS, Universit
´
e de Toulouse, CNRS, Toulouse, France
2
ISAE-SUPAERO, Toulouse, France
Keywords:
Flexible Job-Shop Scheduling, Robust Optimization, Uncertainty Budget, Mixed Integer Linear
Programming, Constraint Programming.
Abstract:
This paper addresses the robust flexible job-shop scheduling problem considering uncertain operation pro-
cessing times associated with an uncertainty budget. Exact solution methods based on mixed integer linear
programming and constraint programming are proposed to solve the problem. Such solutions are hybridized in
the framework of a two-stage robust optimization, and a column and constraint generation algorithm is used to
solve representative instances. The experimental results show the advantages of a two-stage approach where
constraint programming and integer programming are mixed to solve a master problem and a subproblem,
respectively.
1 INTRODUCTION
The job-shop scheduling problem is a well studied
and NP-hard problem where a set of jobs are to be
processed on a set of machines (Garey et al., 1976).
Each job is composed of a sequence of operations that
must be processed on machines with given processing
times in a given job-dependent order, and each ma-
chine can process only one operation at a time. The
flexible job-shop problem (FJSSP) is a generalization
of the job-shop scheduling problem: for each oper-
ation, there exists a set of eligible machines. This
makes the problem more difficult to solve, as it con-
sists of both a machine allocation and a sequencing
problem. The FJSSP has received considerable atten-
tion and both metaheuristics and exact methods have
been developed to solve the problem, the majority of
them with the assumption that the parameters are de-
terministically known (Brandimarte, 1993; Dauz
`
ere-
P
´
er
`
es and Paulli, 1997). However, in the real world,
many sources of uncertainty (processing times varia-
tion, machine breakdown, addition of new operations,
etc.) can affect the quality and even the feasibility of
a schedule.
There exist two major approaches to deal with
data uncertainty: stochastic optimization and robust
a
https://orcid.org/0000-0001-5975-7639
b
https://orcid.org/0000-0003-0413-3188
optimization. While stochastic optimization consid-
ers probability distribution, robust optimization as-
sumes that uncertain data belong to a given uncer-
tainty set and aims to optimize performance consid-
ering the worst-case scenario within that set.
In this paper, we propose exact solution meth-
ods to solve the robust flexible job-shop scheduling
problem. A two-stage robust optimization is used to
deal with processing times uncertainty, where the first
stage fixes the assignment and the sequence of opera-
tions on machines whilst the second stage sets the op-
eration start times. We provide two robust counterpart
models based on mixed-integer linear programming
and constraint programming formulations, as well as
a column and constraint generation algorithm. A dis-
cussion is conducted on the basis of an analysis of
experimental results.
2 PROBLEM DEFINITION
2.1 Deterministic Flexible Job-Shop
Scheduling Problem
We first introduce the flexible job-shop scheduling
problem (FJSSP) with makespan minimization. An
instance of the FJSSP implies a set of jobs J and a set
of machines M . Each job i J consists of a sequence
Juvin, C., Houssin, L. and Lopez, P.
Hybrid Methods to Solve the Two-Stage Robust Flexible Job-Shop Scheduling Problem with Budgeted Uncertainty.
DOI: 10.5220/0011619700003396
In Proceedings of the 12th International Conference on Operations Research and Enterprise Systems (ICORES 2023), pages 135-142
ISBN: 978-989-758-627-9; ISSN: 2184-4372
Copyright
c
2023 by SCITEPRESS Science and Technology Publications, Lda. Under CC license (CC BY-NC-ND 4.0)
135
of n
i
operations. The j
th
operation O
i, j
O
i
of a job
i must be performed by one of the machines from the
set of eligible machines M
i, j
M . Let p
i, j,m
denote
the processing time of operation O
i, j
that is processed
on machine m M
i, j
. Each machine can process at
most one operation at a time and preemption is not
allowed: once an operation is started, it must be pro-
cessed without any interruption. The objective is to
find an assignment for each operation and a sequence
on each machine that minimize the maximum com-
pletion time or makespan C
max
.
Notations and Definitions.
J Set of jobs
M Set of machines
n
i
Number of operations in job i (i J )
O
i
Set of operations in job i (i J )
O
i, j
j
th
operation of job i (i J , j {1, . . . , n
i
})
M
i, j
Set of eligible machines for operation
O
i, j
(i J , O
i, j
O
i
)
p
i, j,m
Processing time of operation O
i, j
on
machine m (i J , O
i, j
O
i
, m M
i, j
)
I
m
Set of operations that can be processed by
machine m (m M )
H Big constant
2.2 Flexible Job-Shop Scheduling
Problem with Uncertain Processing
Times
We consider that the processing times of operations
are uncertain. Each processing time p
i, j,m
of an oper-
ation O
i, j
O
i
, i J , on machine m M
i, j
, belongs to
the interval [ ¯p
i, j,m
, ¯p
i, j,m
+ ˆp
i, j,m
], where ¯p
i, j,m
is the
nominal value and ˆp
i, j,m
the maximum deviation of
the processing time from its nominal value.
Example 1. Consider an FJSSP instance with 3 jobs
and 2 machines. The intervals [ ¯p
i, j,m
, ¯p
i, j,m
+ ˆp
i, j,m
]
of processing times p
i, j,m
of operations O
i, j
O
i
, i
J on each eligible machine m M
i, j
, are given in Ta-
ble 1.
Table 1: Numerical example of an instance of the FJSSP:
operation processing times.
M1 M2
O
1,1
[43; 86]
J1 O
1,2
[87; 170] [95; 190]
O
2,1
[63; 142] [53; 166]
J2 O
2,2
[73; 131]
O
3,1
[125; 239] [135; 224]
J3 O
3,2
[43; 73] [61; 174]
2.2.1 Uncertainty Budget
The traditional robust optimization approach (Soys-
ter, 1973) consists in protecting against the case when
all parameters can deviate at the same time, which
makes the solution overly conservative. Indeed, there
is a very low probability that all parameters take their
worst value all together. To overcome this limitation,
(Bertsimas and Sim, 2004) introduce an uncertainty
budget approach that allows a restriction on the num-
ber of deviations that can occur simultaneously to a
given budget. In order to reach a trade-off between
robustness and solution quality, we exploit this ap-
proach to define the uncertainty set.
Let Γ be the budget of uncertainty, the maximum
number of operations whose processing time devia-
tion can occur simultaneously. The worst-case sce-
nario is always an extremum scenario (Ben-Tal et al.,
2009). Thus, for each scenario ξ, the processing time
of operation O
i, j
on machine m is given by:
p
i, j,m
(ξ) = ¯p
i, j,m
+ ξ
i, j
· ˆp
i, j,m
where ξ
i, j
is equal to 1 if the processing time of the
operation deviates, 0 otherwise.
We define the uncertainty set U
Γ
as:
U
Γ
= {(ξ
i, j
)
iJ ,1 jn
i
|
iJ
n
i
j=1
ξ
i, j
Γ}
2.2.2 Multi-Stage Robust Optimization
Multi-stage robust optimization has been introduced
by (Ben-Tal et al., 2004). In some optimization prob-
lems, only part of the decision variables have to be
fixed before uncertainty is revealed, while the other
variables can be chosen after the realization and can
thus be adjusted to the scenario. The authors intro-
duce the adjustable robust counterpart; the set of de-
cision variables is split into “here and now” decisions
and “wait and see” decisions. The objective is to find
a solution for the “here and now” decision variables
such that constraints involving uncertain parameters
remain feasible for all values of the uncertain param-
eters, and minimizing the objective value.
In our problem, we consider that the purpose is
to find the assignment and sequence on the machines
(first stage: here and now), allowing to define a start
time for each operation and each scenario (second
stage: wait and see), minimizing the makespan in the
worst-case scenario considering the budget of uncer-
tainty.
Example 2. Considering Example 1, a feasible solu-
tion is the assignment of operations O
1,1
, O
3,1
, O
3,2
to
machine M
1
, and of operations O
2,1
, O
2,2
, O
1,2
to ma-
chine M
2
, following these sequences. Figure 1 repre-
sents this solution when all processing times take their
ICORES 2023 - 12th International Conference on Operations Research and Enterprise Systems
136
nominal value; the makespan is 221. Considering an
uncertainty budget Γ = 2, the worst case, for this so-
lution, is that the processing time of operations O
2,1
and O
1,2
deviate and take their greatest value. Fig-
ure 2 shows the Gantt chart in this case. The objec-
tive function value of this solution for an uncertainty
budget Γ = 2 reaches the makespan equal to 429.

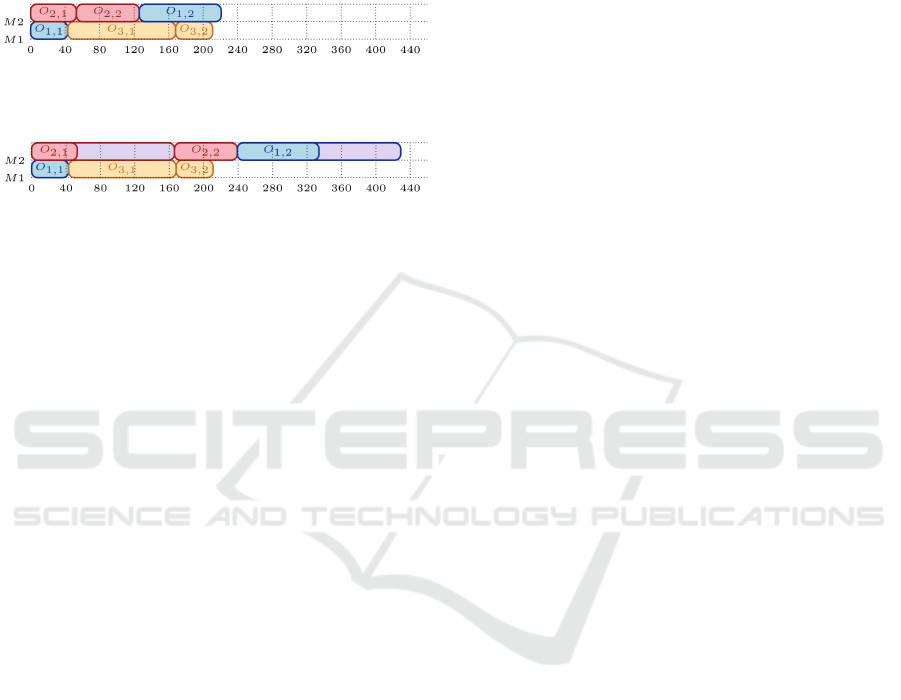

Figure 1: A feasible solution for Example 1, when all pro-
cessing times take their nominal value.
Figure 2: From the solution of Figure 1, the worst-case so-
lution with an uncertainty budget of 2.
3 ROBUST COUNTERPART FOR
THE FJSSP
Two robust counterparts of the flexible job-shop
scheduling problem are presented. They are respec-
tively based on a Mixed Integer Linear Programming
formulation and a Constraint Programming model for
the deterministic FJSSP.
3.1 Mixed Integer Linear Programming
Model
We define a Mixed Integer Linear Programming
(MILP) extended robust model, which is directly
inspired by the sequence-based model made by (Shen
et al., 2018). The first stage decision variables are
defined as follows:
x
i, j,m
=
1 if operation O
i, j
is processed on
machine m;
0 otherwise
y
i, j,i
0
, j
0
=
1 if operation O
i, j
is processed before
O
i
0
, j
0
;
0 otherwise
while the start time t
i, j
(ξ) R
+
of each operation O
i, j
in scenario ξ is part of the second stage variables.
The MILP model is as follows:
minC
max
(1)
s.t.
mM
i, j
x
i, j,m
= 1 i J , j O
i
(2)
mM
i, j1
x
i, j1,m
· p
i, j1,m
(ξ) +t
i, j1
(ξ) t
i, j
(ξ)
i J , j O
i
, ξ U
Γ
(3)
t
i
0
, j
0
(ξ) + p
i
0
, j
0
,m
(ξ) (2 x
i, j,m
x
i
0
, j
0
,m
+ y
i, j,i
0
, j
0
) · H
t
i, j
(ξ) m M , (O
i, j
, O
i, j
0
) I
2
m
, ξ U
Γ
(4)
t
i, j
(ξ) + p
i, j,m
(ξ) (3 x
i, j,m
x
i
0
, j
0
,m
y
i, j,i
0
, j
0
) · H
t
i
0
, j
0
(ξ) m M , (O
i, j
, O
i, j
0
) I
2
m
, ξ U
Γ
(5)
t
i,n
i
(ξ) +
mM
i,n
i
x
i,n
i
,m
· p
i,n
i
,m
(ξ) C
max
i J , ξ U
Γ
(6)
x
i, j,m
{
0, 1
}
i J , j O
i
, m M
i, j
(7)
y
i, j,i
0
, j
0
{
0, 1
}
(i, i
0
) J
2
, j O
i
, j
0
O
i
0
(8)
The objective (1) is to minimize the makespan
C
max
. Constraints (2) are assignment constraints and
ensure that each operation is assigned to exactly one
machine. Constraints (3) ensure the precedence rela-
tion between two consecutive operations of the same
job. Constraints (4) and (5) are the disjunctive con-
straints and avoid overlapping of operations sched-
uled on the same machine. Note that Constraints (3),
(4) and (5) are duplicated for each feasible scenario.
Finally, Constraints (6) allow to compute the greatest
makespan among all feasible scenarios and therefore
to determine the optimal solution in the worst case.
Finally, Constraints (7) and (8) define the domain of
the variables.
3.2 Constraint Programming Model
While Constraint Programming (CP) obtains very
good results in scheduling, to the best of our knowl-
edge it has been never used in robust multi-stage mod-
els. The following model is directly inspired from
(Kress and M
¨
uller, 2019) for the deterministic FJSSP
with machine operator constraints. It involves the fol-
lowing variables:
task
i, j,ξ
: interval variable between the start and
the end of the processing of operation O
i, j
in sce-
nario ξ;
mode
i, j,m,ξ
: interval variable between the start and
the end of the processing of operation O
i, j
on ma-
chine m in scenario ξ (since the operations have
multiple eligible machines and must be executed
by exactly one of them, this is an optional vari-
able);
seqs
m,ξ
: sequence variable of tasks scheduled on
machine m in scenario ξ.
Hybrid Methods to Solve the Two-Stage Robust Flexible Job-Shop Scheduling Problem with Budgeted Uncertainty
137
The CP model is as follows:
minC
max
(9)
s.t.
C
max
task
i,n
i
,ξ
.end i J , ξ U
Γ
(10)
EndBe f oreStart(task
i, j,ξ
,task
i, j+1,ξ
)
i J , O
i, j
O
i
\ {O
i,n
i
}, ξ U
Γ
(11)
Al ternative(task
i, j,ξ
, mode
i, j,m,ξ
: m M
i, j
)
i J , O
i, j
O
i
, ξ U
Γ
(12)
NoOverlap(seqs
m,ξ
) m M , ξ U
Γ
(13)
PresenceO f (mode
i, j,m,0
) PresenceO f (mode
i, j,m,ξ
)
i J , O
i, j
O
i
, m M
i, j
, ξ U
Γ
\ {0} (14)
SameSequence(seqs
m,0
, seqs
m,ξ
)
m M , ξ U
Γ
\ {0} (15)
Constraints (10) allow the determination of the
makespan, which is equal to the end of the last op-
eration. Constraints (11) ensure the precedence rela-
tion between two consecutive operations of the same
job. Constraints (12) ensure that each operation is as-
signed to exactly one machine. Constraints (13) en-
sure that in each scenario each machine performs at
most only one operation at the same time. Constraints
(10–13) are duplicated for each scenario. Constraints
(14) and (15) ensure that the assignment of each oper-
ation and the sequence on each machine are the same
in each scenario. For these last two constraints, the
first scenario ξ = 0 is used as reference.
4 COLUMN AND CONSTRAINT
GENERATION APPLIED TO
THE FJSSP
We present here a column and constraint genera-
tion approach to solve the robust flexible job-shop
scheduling problem. This method has been intro-
duced by (Zeng and Zhao, 2013) to solve two-stage
robust optimization problems. The procedure splits
the problem into a master problem and an adversarial
subproblem. The idea is to solve the robust counter-
part problem (or master problem), for a limited sub-
set of scenarios, and then to identify which scenarios,
if any, make the found solution infeasible, using an
adversarial subproblem. Then, these scenarios are in-
cluded in the master problem by generating the corre-
sponding recourse decision variables on the fly. This
process repeats until a solution that is feasible for all
scenarios is found (Hamaz et al., 2018; Duarte et al.,
2020; Silva et al., 2020; Levorato et al., 2022).
4.1 Column and Constraint Algorithm
For the FJSSP, the master problem can be defined as
one of the extended models presented in Section 3,
for which only a subset of scenarios is considered, i.e.
each robust constraint ((3–6) for the MILP model or
(10–13) for the CP model) is defined only for a sub-
set of scenarios. An optimal solution for this mas-
ter problem allows us to obtain a lower bound on the
makespan for the global problem. In order to verify
the feasibility of this solution, given the assignments
and sequences on the machines fixed in the master
problem, we check whether one of the possible sce-
narios leads to a greater makespan than the one found
in the master problem. If such a scenario exists, then
the variables and constraints associated with it are
generated and added to the master problem. In our
case, the search for such a scenario can be seen as the
search for the scenario that leads to the largest possi-
ble makespan.
Figure 3 depicts the scheme of the column and
constraint generation algorithm, where LB represents
the lower bound and UB the upper bound.
Master Problem: robust FJSSP
LB update
Worst case evaluation
UB update
Optimal assignment
and sequences
Add worst scenario :
variables and constraints
fixed assignment
and sequences
LB = UB
LB < UB
Figure 3: Column and constraint algorithm.
4.2 Worst-Case Evaluation
Having assigned and sequenced operations on ma-
chines via the master problem, we know all prece-
dence relations between operations, both the prece-
dences in the jobs induced by the problem, and the
precedences on the machines fixed in the master prob-
lem. The resulting problem corresponds to the evalu-
ation of the worst-case scenario: Given an uncertainty
budget Γ, the aim is to identify the Γ deviating opera-
tions that lead to the greatest makespan.
ICORES 2023 - 12th International Conference on Operations Research and Enterprise Systems
138
4.2.1 Mixed Integer Linear Programming
We introduce a MILP model with the following deci-
sions variables:
ξ
i, j
=
1 if processing time of operation O
i, j
deviates;
0 otherwise
b
i, j,i
0
, j
0
=
1 if operation O
i, j
starts at the end
of operation O
i
0
, j
0
;
0 otherwise
d
i
=
1 if the last operation O
i,n
i
of job i is the
last operation among all to be completed;
0 otherwise
Let also A
i, j
be the set of immediate predecessors
of operation O
i, j
.
The MILP model developed for the worst-case
scenario evaluation is as follows:
max C
max
(16)
s.t.
iJ
jO
i
ξ
i, j
= Γ (17)
t
i, j
(t
i
0
, j
0
+ ¯p
i
0
, j
0
+ ξ
i,
0
j
0
· ˆp
i
0
, j
0
) H · (1 b
i, j,i
0
, j
0
)
i J , j O
i
, (i
0
, j
0
) A
i, j
(18)
(i
0
, j
0
)A
i, j
b
i, j,i
0
, j
0
1 i J , j O
i
| A
i, j
6=
/
0 (19)
t
i,1
= 0 i J | A
i,0
=
/
0 (20)
C
max
(t
i,n
i
+ ¯p
i,n
i
+ ξ
i,n
i
· ˆp
i,n
i
) H · (1 d
i
)
i J (21)
ξ
i, j
{
0, 1
}
i J , j O
i
(22)
b
i, j,i
0
, j
0
{
0, 1
}
i J , j O
i
, (i
0
, j
0
) A
i, j
(23)
d
i
{
0, 1
}
i J (24)
The objective is to find the scenario (the values
of ξ
i, j
for each operation O
i, j
) that maximizes the
makespan (16). Constraints (17) ensure that exactly
Γ operations have their processing time deviating.
Constraints (18) and (19) ensure that each operation,
which has at least one predecessor, starts at the max-
imum time among the completion time of the prede-
cessors. Constraints (20) ensure that operations with
no predecessor start at time 0. Constraints (21) ensure
that the makespan is equal to the latest completion
time among all jobs.
4.2.2 Constraint Programming
We introduce a CP model with optional interval vari-
ables dev
i, j
, which are present only if the process-
ing time of the corresponding operation O
i, j
takes its
maximum value (i.e. the operation deviates from its
nominal value). Let us define the decision variables
used to model the subproblem as follows:
task
i, j
, interval variable associated to operation
O
i, j
of duration ¯p
i, j,m
;
dev
i, j
, optional interval variable of duration ˆp
i, j,m
,
present if operation O
i, j
deviates from its nominal
value.
We also use function HeightAtStart, which gives the
contribution of an interval variable to a cumulative
function at its start point, and the cumulative func-
tion StepAtStart, which defines the contribution of an
interval at its start.
maxC
max
(25)
s.t.
task
i,1
.start = 0 i J | A
i,1
=
/
0 (26)
task
i, j
.start = max({task
i
0
, j
0
.end | O
i
0
, j
0
A
i, j
})
i J , O
i, j
O
i
(27)
StartAtEnd(dev
i, j
,task
i, j
) i J ,O
i, j
O
i
(28)
iJ
jO
i
HeightAtStart(dev
i, j
, StepAtStart(dev
i, j
, 1))
= Γ (29)
C
max
= max(
iJ
({task
i,n
i
.end} {dev
i,n
i
.end}))
(30)
The objective is to find the scenario (by deter-
mining which optional interval variables dev
i, j
are
present) that maximizes the makespan (25). Con-
straints (27) and (28) ensure that each operation starts
as soon as possible, given the assignment and the
sequencing determined by the master problem, and
the precedence constraints. Constraints (29) ensure
that if the interval variable dev
i, j
is present, meaning
that the processing time of the corresponding opera-
tion O
i, j
deviates from its nominal value, this process-
ing time is equal to its maximum value. Constraints
(29) ensure that exactly Γ operations take their maxi-
mum values for their processing times. Finally, Con-
straints (30) ensure that the makespan is equal to the
latest completion time among all jobs.
Hybrid Methods to Solve the Two-Stage Robust Flexible Job-Shop Scheduling Problem with Budgeted Uncertainty
139
5 EXPERIMENTAL RESULTS
For computational tests, all experiments are per-
formed on three cluster nodes with Intel Xeon E5-
2695 v4 CPU at 2.1 GHz. All algorithms presented
are implemented in C++, using CPLEX 12.10 for the
MILP models and CP Optimizer (CPO) 12.10 for the
CP models. CPU time and RAM are respectively lim-
ited to 1 hour and 16 GB.
5.1 Instances and Methods
The instances we used for our tests are small- and
medium-size problems instances for the FJSSP taken
from (Fattahi et al., 2007) (whose features are de-
scribed in Table 2), adapted to the robust problem by
randomly generating values for the deviations. Let
¯p
max
be the maximum nominal processing time for
all operations and all machines. For each operation
O
i, j
and each eligible machine m M
i, j
, we randomly
generate a value for ˆp
i, j,m
within a range from 25 % to
100 % of the value of ¯p
max
. We repeat this operation
three times; we therefore obtain three new instances
from one initial deterministic instance. We generate
in total 60 instances that we use for our tests. We
tested all the models by varying the budget of uncer-
tainty according to four ratios, namely 20 %, 40 %,
60 % and 80 % of the number of operations rounded
down to the nearest integer, giving a total of 240 ex-
periments per method.
In addition to the two extended models presented
in Section 3, we evaluate four combinations of the
column and constraint algorithm presented in Sec-
tion 4. Table 3 presents the name and configuration of
each tested method (ccg stands for column and con-
straint generation).
5.2 Results
Table 4 presents general results comparing the per-
formance of the methods for all instances, by report-
ing the number of instances that each method is able
to solve within the time limit. If we focus on the
extended methods, we notice that the CP formula-
tion performs slightly better than the MILP method.
Secondly, we note that methods based on column
and constraint generation allow to solve considerably
more instances than extended methods. More specif-
ically, those using a CP formulation for the master
problem are the ones with the best results. Finally, we
observe that the resolution of the adversarial subprob-
lem with MILP provides a marginally better perfor-
mance than with the CP model.
Table 5 reports, for each original instance, the
Table 2: Characteristics of FJSSP instances.
Instance #Jobs #Machines #Operations
SFJS1 2 2 4
SFJS2 2 2 4
SFJS3 3 2 6
SFJS4 3 2 6
SFJS5 3 2 6
SFJS6 3 3 9
SFJS7 3 5 9
SFJS8 3 4 9
SFJS9 3 3 9
SFJS10 4 5 12
MFJS1 5 6 15
MFJS2 5 7 15
MFJS3 6 7 18
MFJS4 7 7 21
MFJS5 7 7 21
MFJS6 8 7 24
MFJS7 8 7 32
MFJS8 9 8 36
MFJS9 11 8 44
MFJS10 12 8 48
Table 3: Methods description.
Method Method Robust Sub-
name type counterpart problem
milp extended milp
cp extended cp
ccg milp ccg milp milp
ccg milp cp ccg milp cp
ccg cp ccg cp cp
ccg cp milp ccg cp milp
Table 4: Methods performance comparison (number of in-
stances, out of 240, solved to optimality).
Method #Solv.
milp 130
cp 133
ccg milp 167
ccg milp cp 166
ccg cp 190
ccg cp milp 193
number of robust instances (among the 12) solved to
optimality by each method and the average time to
achieve it. Not surprisingly, we observe that the more
the size of the instances increases the more difficult
they are to solve, visible by a decreasing number of
solved instances and an increasing CPU time. Ex-
tended methods manage to solve all instances up to
4 jobs and 5 machines while ‘ccg cp milp’ solves all
instances up to 6 jobs and 7 machines.
Table 6 aims to visualize the performance of the
ICORES 2023 - 12th International Conference on Operations Research and Enterprise Systems
140
Table 5: Methods performance comparison grouping by instances (number of instances, out of 12, solved to optimality).
Instance milp cp ccg milp ccg milp cp ccg cp ccg cp milp
#Solv. t(s) #Solv. t(s) #Solv. t(s) #Solv. t(s) #Solv. t(s) #Solv. t(s)
SFJS1 12 0.04 12 0.03 12 0.06 12 0.98 12 1.13 12 0.05
SFJS2 12 0.03 12 0.03 12 0.03 12 0.25 12 0.38 12 0.04
SFJS3 12 0.4 12 0.08 12 0.5 12 3.03 12 3.17 12 0.11
SFJS4 12 0.25 12 0.05 12 0.23 12 1.65 12 1.77 12 0.08
SFJS5 12 0.83 12 0.12 12 1.03 12 2.93 12 3.8 12 0.2
SFJS6 12 4.55 12 0.44 12 1.49 12 5.62 12 4.89 12 0.25
SFJS7 12 1.3 12 0.25 12 0.31 12 1.46 12 1.73 12 0.11
SFJS8 12 7.32 12 0.62 12 1.79 12 5.68 12 6.22 12 0.31
SFJS9 12 11.5 12 2.05 12 1.42 12 2.47 12 3.19 12 0.16
SFJS10 12 128 12 3.1 12 2.01 12 8.59 12 11.5 12 0.2
MFJS1 6 1115 6 1445 12 257 12 297 12 73.1 12 19.9
MFJS2 4 1246 6 858 12 161 12 199 12 44.6 12 9.55
MFJS3 0 - 1 1301 11 549 10 414 11 174 12 99.5
MFJS4 0 - 0 - 5 849 5 1715 11 539 11 450
MFJS5 0 - 0 - 5 694 6 1089 10 544 10 328
MFJS6 0 - 0 - 2 1643 1 2522 7 255 9 739
MFJS7 0 - 0 - 0 - 0 - 4 1006 4 815
MFJS8 0 - 0 - 0 - 0 - 3 1144 3 880
MFJS9 0 - 0 - 0 - 0 - 0 - 0 -
MFJS10 0 - 0 - 0 - 0 - 0 - 0 -
Table 6: Methods performance comparison grouping by uncertainty budget (number of instances, out of 60, solved to opti-
mality).
Uncertainty budget milp cp ccg milp ccg milp cp ccg cp ccg cp milp
20 % 35 37 38 38 42 42
40 % 30 31 39 39 45 48
60 % 30 30 42 43 49 49
80 % 35 35 48 46 54 54
methods according to the given uncertainty budget.
We notice that for the extended methods, the resolu-
tion is more difficult for medium budget (40 % and
60 %); this is due to the fact that these uncertainty
budgets generate a greater number of scenarios and,
in these methods, the number of decision variables is
directly related to the number of scenarios. However,
for methods based on the column and constraint gen-
eration algorithm, the number of instances solved to
optimality increases with the uncertainty budget. It
shows that the number of scenarios has no direct ef-
fect on the difficulty of the problem.
6 CONCLUSIONS
In this paper, we consider the two-stage flexible job-
shop scheduling problem where the operation pro-
cessing times are subject to uncertainty. The first
stage is devoted to fixing the assignment and sequenc-
ing decisions; the second stage determines the start
time of the operations.
As a main contribution, we introduce two robust
counterpart formulations to solve the robust schedul-
ing problem, including one based on constraint pro-
gramming. We use a column and constraint gener-
ation algorithm mixing both integer linear program-
ming and constraint programming. Experimental re-
sults show that the best method, among those tested
in this study, is the constraint and column generation
method using constraint programming in the master
problem and an integer linear programming model for
the subproblem.
REFERENCES
Ben-Tal, A., El Ghaoui, L., and Nemirovski, A. (2009). Ro-
bust optimization, volume 28. Princeton university
press.
Ben-Tal, A., Goryashko, A., Guslitzer, E., and Nemirovski,
A. (2004). Adjustable robust solutions of uncer-
tain linear programs. Mathematical Programming,
99(2):351–376.
Bertsimas, D. and Sim, M. (2004). The price of robustness.
Hybrid Methods to Solve the Two-Stage Robust Flexible Job-Shop Scheduling Problem with Budgeted Uncertainty
141
Operations Research, 52(1):35–53.
Brandimarte, P. (1993). Routing and scheduling in a flex-
ible job shop by tabu search. Annals of Operations
Research, 41(3):157–183.
Dauz
`
ere-P
´
er
`
es, S. and Paulli, J. (1997). An integrated ap-
proach for modeling and solving the general multipro-
cessor job-shop scheduling problem using tabu search.
Annals of Operations Research, 70:281–306.
Duarte, J. L. R., Fan, N., and Jin, T. (2020). Multi-process
production scheduling with variable renewable inte-
gration and demand response. European Journal of
Operational Research, 281(1):186–200.
Fattahi, P., Mehrabad, M. S., and Jolai, F. (2007). Mathe-
matical modeling and heuristic approaches to flexible
job shop scheduling problems. Journal of Intelligent
Manufacturing, 18(3):331–342.
Garey, M. R., Johnson, D. S., and Sethi, R. (1976).
The complexity of flowshop and jobshop scheduling.
Mathematics of Operations Research, 1(2):117–129.
Hamaz, I., Houssin, L., and Cafieri, S. (2018). The cyclic
job shop problem with uncertain processing times.
In 16th International Conference on Project Manage-
ment and Scheduling (PMS 2018), pages 119–122,
Rome, Italy.
Kress, D. and M
¨
uller, D. (2019). Mathematical models for
a flexible job shop scheduling problem with machine
operator constraints. IFAC-PapersOnLine, 52(13):94–
99.
Levorato, M., Figueiredo, R., and Frota, Y. (2022). Exact
solutions for the two-machine robust flow shop with
budgeted uncertainty. European Journal of Opera-
tional Research, 300(1):46–57.
Shen, L., Dauz
`
ere-P
´
er
`
es, S., and Neufeld, J. S. (2018).
Solving the flexible job shop scheduling problem with
sequence-dependent setup times. European Journal of
Operational Research, 265(2):503–516.
Silva, M., Poss, M., and Maculan, N. (2020). Solution al-
gorithms for minimizing the total tardiness with bud-
geted processing time uncertainty. European Journal
of Operational Research, 283(1):70–82.
Soyster, A. L. (1973). Convex programming with set-
inclusive constraints and applications to inexact lin-
ear programming. Operations Research, 21(5):1154–
1157.
Zeng, B. and Zhao, L. (2013). Solving two-stage robust
optimization problems using a column-and-constraint
generation method. Operations Research Letters,
41(5):457–461.
ICORES 2023 - 12th International Conference on Operations Research and Enterprise Systems
142
